Project
Schedule

*Dates subject to change

Construction Phases

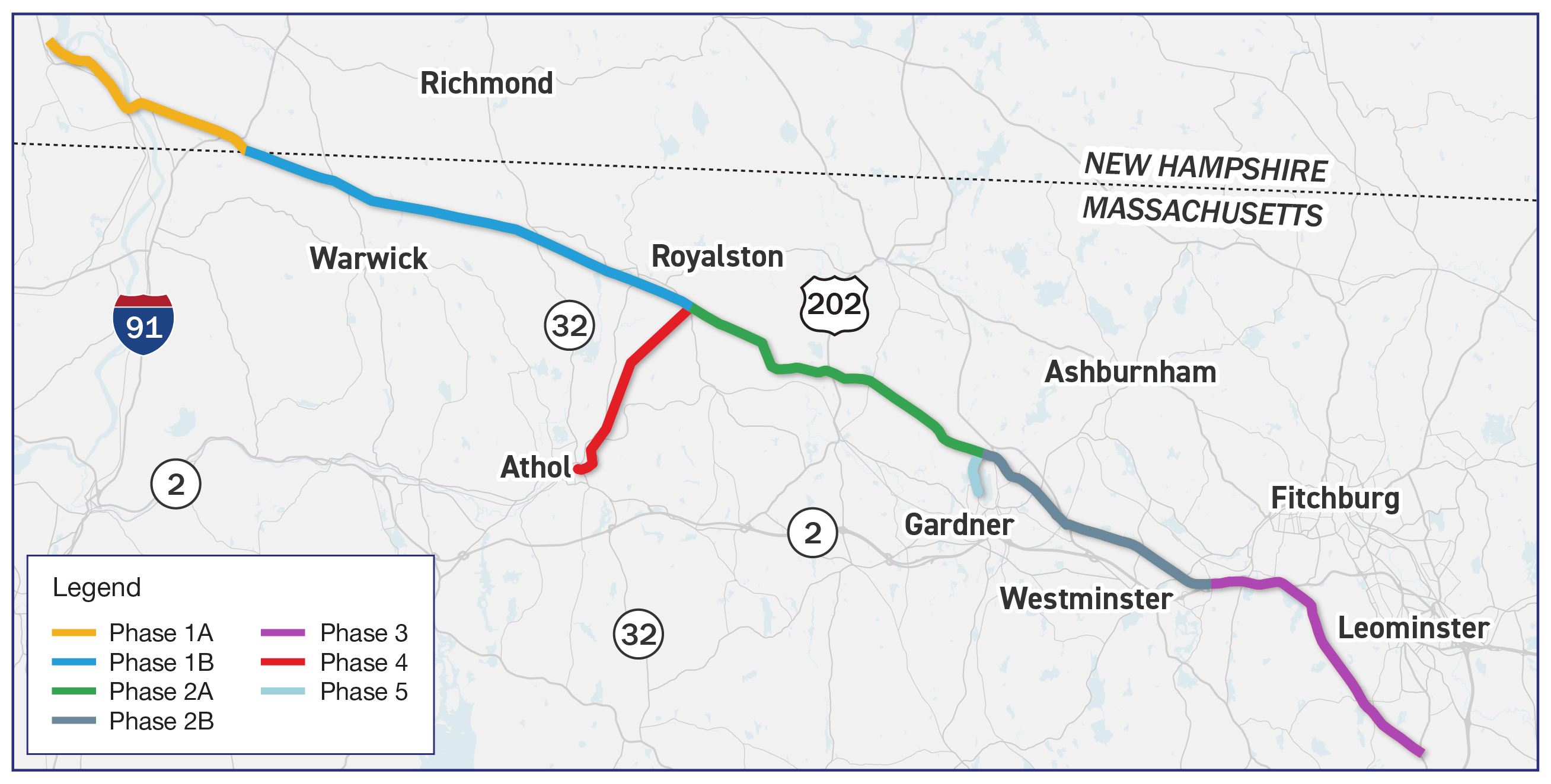

Map of construction phases

Vegetation Management

  • All project towns and cities
    • Ongoing - 2030

Phase 1A

  • Vernon, VT to Hinsdale and Winchester, NH
    • Construction complete

Phase 1B

  • Warwick to the Royalston 701 substation (on South Royalston Rd. Royalston, MA)
    • June 2026 - January 2028

Phase 5

  • Gardner, MA (the Crystal Lake Taps)
    • June 2026 - December 2027

Phase 3

  • Westminster, Fitchburg, Leominster, and Sterling, MA (East Westminster Substation to Pratts Junction Substation)
    • August 2026 - December 2028

Phase 2A

  • Royalston, Winchendon, and Gardner, MA
    • April 2028 - December 2029

Phase 2B

  • Gardner and Westminster, MA
    • August 2027 - February 2029

Phase 4

  • Chestnut Hill Taps (Athol, MA)
    • May 2029 - December 2030

Project Permitting and Approvals

All necessary permits have been received. These permitting reviews include federal, state and local permits by town.

Federal Permitting

  • U.S. Army Corps of Engineers (USACE) - Authorization under Section 404 of the Clean Water Act and Section 10 of the Rivers and Harbors Act
  • Consultations under Section 106 of the National Historic Preservation Act and Section 7 of the Endangered Species Act
  • United States Environmental Protection Agency (EPA) - National Pollutant Discharge Elimination System (NPDES) General Permit for Stormwater Discharges and Construction Dewatering Activities/Stormwater Pollution Prevention Plan (SWPPP)
  • Potential filing notices with the Federal Aviation Administration (FAA)

Massachusetts Permitting

  • Energy Facilities Siting Board (EFSB)
  • Executive Office of Energy and Environmental Affairs (EEA) – MEPA Review/Certificate of the Secretary
  • Massachusetts Department of Environmental Protection (MassDEP)-Section 401 Individual Water Quality Certificate, Variance, Waterways Program – Ch. 91 Minor Modification
  • Massachusetts Natural Heritage and Endangered Species Program (NHESP) -Massachusetts Endangered Species Act – Project Review Checklist
  • Potential Conservation and Management Permit Massachusetts Historical Commission (MHC) - Project review under Massachusetts General Law [M.G.L.] c. 9 § 27C
  • Department of Conservation and Recreation (DCR) - Construction Access Permit Massachusetts Department of Transportation (MassDOT) – Highway Crossing and Traffic Management Permit
  • Order of Conditions from each Conservation Commission within the town’s of Athol, Fitchburg, Gardner, Leominster, Sterling, Warwick, Westminster, Winchendon, and Royalston.

New Hampshire Permitting

  • Shoreland Permit by notification to the DES permits NHDOT State Highway Access Permit
  • New Hampshire Department of Environmental Services (DES) - Alteration of Terrain and Wetlands Major/Minor Permit
    • Local New Hampshire Permits:

Vermont Permitting

  • Vermont Public Utility Commission (PUC) Section 248 Petition
  • Vermont Fish and Wildlife Department – Threatened and Endangered Species Taking Permit
  • Vermont Department of Environmental Conservation - Stormwater General Permit, Wetlands General Permit and 401 WQC
